DIAMOND GRINDING AND SHOT BLASTING

Concrete Floor Grinding and Preparation

Concrete floor grinding, shot blasting and moisture testing across the North West, Yorkshire, the Midlands and North East Wales. Carried out under dust extraction as the first stage of a resin installation, or supplied as a standalone preparation package for another trade to finish.

THE STAGE THAT DECIDES EVERYTHING

Nothing Sticks to a Floor You Have Not Prepared

The top layer of a power-floated concrete substrate is laitance: a weak, closed skin of fines and cement paste. Resin bonded to laitance is bonded to something that is already only loosely attached to the concrete underneath it, and it will come away carrying that skin with it.

Concrete floor grinding removes it. It opens the surface, gives the resin a mechanical key, and takes off curing compounds, old coatings, adhesive residue and whatever twenty years of production has soaked into the top few millimetres.

Around 95 per cent of resin floor failures trace back to preparation or specification rather than to the material. Preparation is not the line to compare on price, because it is the line that decides whether anything above it survives.

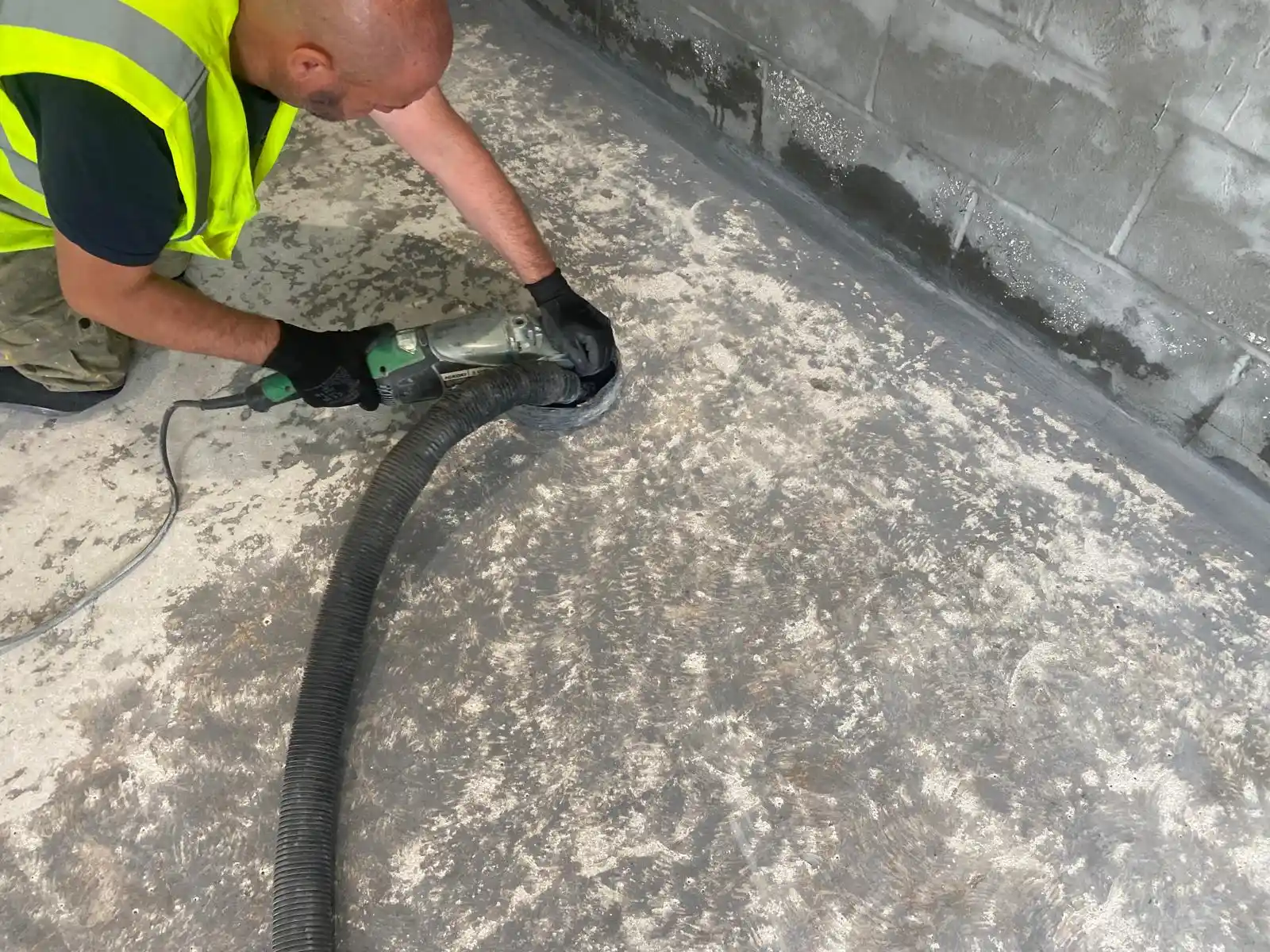

Flatbed diamond grinder carrying out concrete floor grinding before resin flooring
THE RIGHT METHOD FOR THE SUBSTRATE

Concrete Floor Grinding, Blasting and Scabbling

Concrete floor grinding in progress with dust extraction on an industrial floor

Diamond Grinding

The default for most floors. Removes laitance and coatings, flattens minor undulation and leaves a controlled profile. Works right up to walls and around plant.

Shot blasting a concrete floor as an alternative to concrete floor grinding

Shot Blasting

Faster over large open areas and leaves a deeper key for thicker build-ups. Captive blasting recovers the shot and the dust in one pass.

Edge and Detail Work

Handheld grinders take the perimeter, plinths, thresholds and anywhere a ride-on machine cannot reach. Slow, and the part cheap quotes leave out.

Prepared concrete substrate after concrete floor grinding

Scabbling

For heavily contaminated or badly damaged substrates where material has to come off in depth rather than be abraded from the surface.

SILICA IS A COSHH MATTER

Concrete Floor Grinding Without Filling Your Building With Dust

Grinding concrete releases respirable crystalline silica. The workplace exposure limit is 0.1 mg per cubic metre as an eight-hour time-weighted average, and controlling it is a COSHH duty, not a courtesy to whoever works next door.

HEPA Extraction at Source

Every machine runs coupled to an H-class vacuum, so the dust is captured as it is made rather than swept up afterwards.

Contained Working Areas

Screens and negative pressure where the space is shared, so stock, equipment and machinery are not coated by the time we finish.

Documented Controls

COSHH assessment and method statement issued before we arrive, which is what your own health and safety file needs anyway.

PREPARATION IS MORE THAN GRINDING

What Happens After the Machines Stop

Moisture Testing

Relative humidity measured inside the substrate, not at the surface. Standard epoxies tolerate roughly 75 to 80 per cent RH; above that the floor needs a liquid DPM before anything else goes down.

Crack and Joint Repair

Cracks cut out and filled, spalled areas rebuilt, and movement joints treated as joints rather than filled rigid so they do not simply reopen through the new floor.

BEFORE YOU ENQUIRE

Concrete Floor Grinding: Common Questions

Laitance is the weak layer of fines and cement paste left on the surface of a power-floated substrate. It looks like sound concrete but it is only loosely attached to what is underneath. Bond resin to it and the coating eventually lifts, bringing the laitance with it. Grinding removes it.

Grinding is the default: it works up to walls, around plant, removes coatings and flattens minor undulation. Shot blasting is quicker across large open areas and leaves a deeper key for thicker build-ups. On most jobs we use both, blasting the open floor and grinding the perimeter and details.

Far less than people expect when it is done properly. Machines run coupled to H-class vacuum extraction so dust is captured at source, and shared spaces are screened. Grinding concrete releases respirable crystalline silica with a workplace exposure limit of 0.1 mg per cubic metre, so controlling it is a COSHH requirement rather than a preference.

Yes. We supply preparation as a standalone package, including moisture readings and a record of what was done, and hand the deck over for your own contractor to finish. Main contractors on fit-out programmes buy it this way regularly.

Yes, and it is worth doing properly. Preparing around racking, stock and plant is slower, gives a poorer result at the edges and costs more than moving things does. We agree the extent of clearance at survey rather than after the invoice.

It depends on area, what is already on the floor and how much of it is edge work. Removing a failed coating takes considerably longer than opening a clean slab. We give an indicative programme at survey once we know what is actually down.
